If you are in construction, one thing decides whether you make profit or incur loss — your rate analysis. Most contractors lose money not because of lack of work, but because of wrong costing.

This blog will guide you in:

• Calculating accurate rates for materials, labour, and machinery
• Reducing costs using smart planning and efficient resource management
• Using machinery to increase productivity and improve profit margins
• Understanding real Indian market pricing and avoiding underquoting

What is Civil Work Rate Analysis?

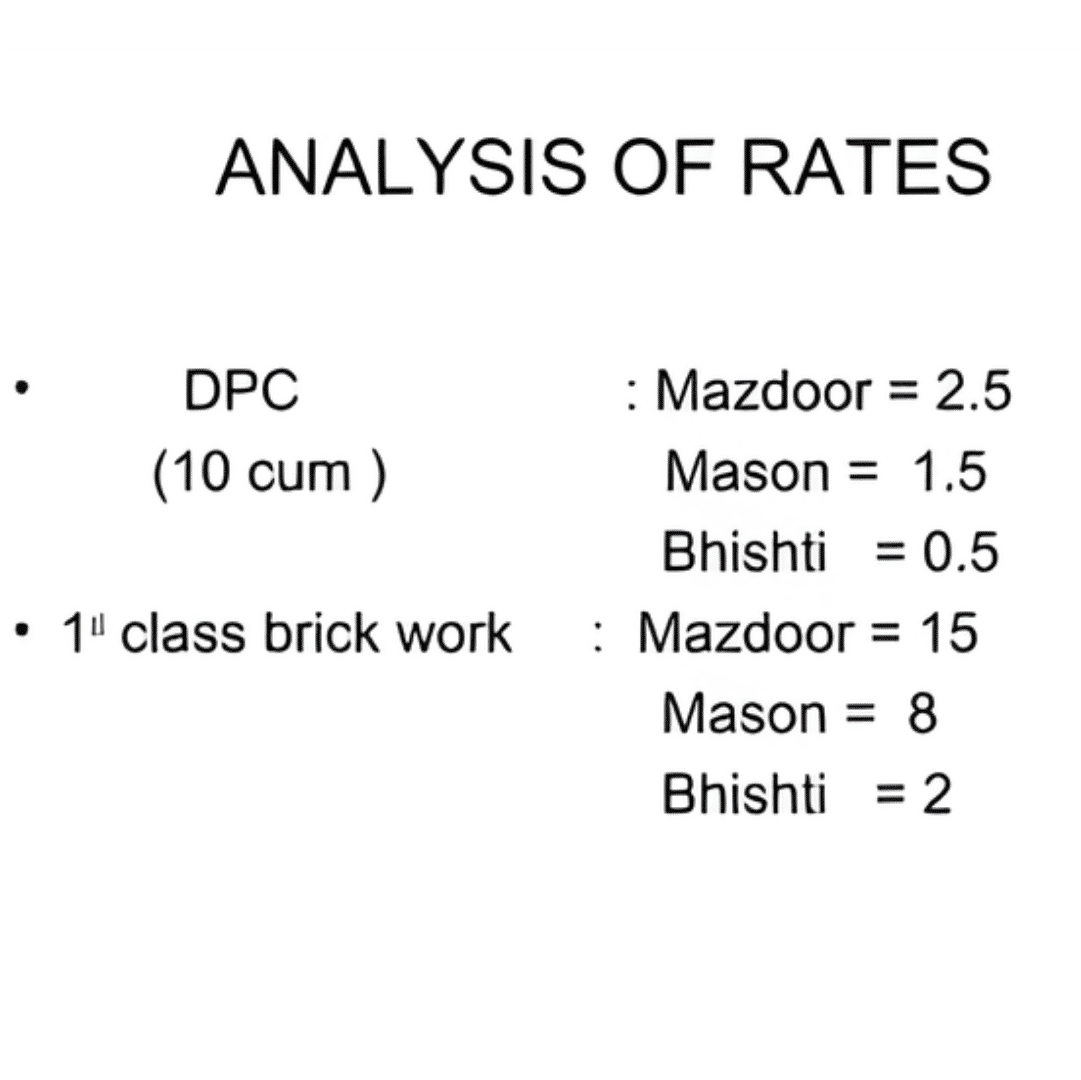

civil work rate

Civil work rate analysis is the process of calculating the cost required to complete one unit of construction work.

For example:

- Concrete → ₹ per m³
- Plaster → ₹ per m²
- Excavation → ₹ per m³

But practically, it answers this:

“1 unit ka kaam complete karne me total kharcha kitna aayega + kitna profit milega?”

Why Civil Work Rate Analysis is Important in 2026

In today’s competitive market, margins are tight. A small mistake in costing can lead to huge losses.

1. Accurate Cost Estimation

If your estimate is wrong by even ₹300–₹500 per unit, your total project loss can go into lakhs.

2. Helps You Win Tenders (Without Loss)

You need to quote:

- Not too high
- Not too low

Rate analysis helps you hit the perfect competitive price.

3. Real-Time Cost Control

During execution, you can compare:

- Estimated cost vs actual cost

This helps you identify:

- Labour inefficiency
- Material wastage
- Cost leakage

4. Profit Optimization

Smart contractors don’t increase rates — they reduce cost per unit using:

- Better planning
- Machinery
- Bulk procurement

Components of Civil Work Rate Analysis

material cost

1. Material Cost (50–70% of Total Cost)

Material is the biggest cost driver in construction projects.

Includes:

- Cement
- Sand
- Aggregate
- Steel
- Bricks

Practical Calculation Example:

For 1 m³ concrete:

- Cement: 8 bags × ₹350 = ₹2800
- Sand: ₹750
- Aggregate: ₹1200

Total Material Cost = ₹4750

labour cost

2. Labour Cost (Productivity Driven)

Labour cost depends on multiple factors such as:

- Skill level
- Location
- Output per day

Example:

- Mason: ₹700–₹1200/day
- Helper: ₹400–₹700/day

For 1 m³ concrete:

- Labour cost ≈ ₹1200–₹1800

Real Insight:

Labour cost is not fixed — it depends on efficiency.

Concrete floor used in warehouses and industrial buildings

3. Equipment / Machinery Cost

This is where most contractors lose money — by ignoring machines.

Machines Used in Civil Works:

- Mini Mixer → Concrete mixing
- Plate Compactor → Soil compaction
- Tamping Rammer → Foundation compaction
- Walk Behind Roller → Road work
- Power Trowel → Floor finishing
- Screed Vibrator → Leveling

When calculating rate:

- Using Mini Mixer reduces labour by 30–40%
- Using Plate Compactor improves density & reduces rework
- Using Power Trowel improves finish & reduces manual effort

Machinery reduces:

- Labour cost
- Time
- Rework

Result = Lower cost per unit + Higher profit

Concrete floor used in warehouses and industrial buildings

4. Overheads (Hidden Cost Killer)

Overheads are indirect costs that many contractors ignore, but they significantly impact overall profitability.

Includes:

- Site engineer salary
- Electricity & water
- Transportation
- Safety gear
- Site office

Typically:

- 5–10% of total project cost

Real Insight:

Ignoring overhead = thinking you’re making profit… but actually you're not.

5.Contractor's Profit

Contractor’s profit depends on multiple factors such as:

- Competition
- Risk
- Project size

Standard:

- 10–20%

Real Insight:

Smart contractors adjust profit strategically based on project conditions.

Civil Work Rate Analysis Formula

Rate Calculation Formula:

Rate = Material + Labour + Equipment + Overheads + Profit

Breakdown:

- Material Cost
- Labour Cost
- Equipment / Machinery Cost
- Overheads
- Contractor’s Profit

Important Note:

But real accuracy depends on how correctly you calculate each component.

Step-by-Step Method (Real Contractor Workflow)

Step 1: Define Work Item

- 1 m³ PCC
- 1 m² plaster

Step 2: Calculate Material Quantity

Use mix design / standard data.

Step 3: Calculate Labour Requirement

Based on output per day.

Step 4: Add Machinery Cost

Use machines like:

- Mini Mixer
- Concrete Cutter
- Power Trowel
- Screed Vibrator

Step 5: Add Overheads

Include all indirect costs.

Step 6: Add Profit

Strategic decision based on project conditions.

Step 7: Final Rate

- Get ₹ per unit

Key Insight:

This step differentiates an average contractor from a smart contractor.

Latest Approximate Civil Work Rates in India (2026)
Work Type Rate Range
PCC Concrete ₹7000 – ₹8500 / m³
RCC Concrete ₹9000 – ₹12000 / m³
Brickwork ₹800 – ₹1500 / m²
Plaster ₹150 – ₹300 / m²
Excavation ₹150 – ₹400 / m³
Case Study (Real Insight – Cost Saving)

A contractor who was using manual mixing later switched to a Mini Mixer.

It resulted in:

- Labour reduced by 35%
- Work speed increased by 40%
- Cost per m³ reduced by ₹400–₹600

On a 1000 m³ project:

➡ Savings = ₹4–6 Lakhs

Types of Rate Analysis in Civil Engineering

1. Detailed Rate Analysis

Detailed rate analysis is the most accurate and widely used method in construction projects. In this type, every component involved in completing a work item is calculated in detail.

It includes:

- Exact quantities of materials (cement, sand, aggregate, steel)
- Labour requirements (skilled and unskilled workers)
- Equipment usage
- Transportation
- Overheads
- Contractor profit

Each element is calculated step-by-step using standard data, mix design, and real market rates. For example, if you are analyzing the rate of 1 m³ concrete, you will calculate how many bags of cement are required, how much sand and aggregate will be used, how many labourers are needed, and how much machinery will cost.

2. Approximate Rate Analysis

Approximate rate analysis is used when a quick estimation is required, especially during the initial planning or feasibility stage of a project.

In this method:

- Standard rates are used
- Past project data is referred

For example, instead of calculating individual material quantities, a contractor may use an average rate like ₹7,500 per m³ for concrete based on previous experience. This method saves time and helps in quick decision-making, such as budgeting or comparing project options.

3. SOR (Schedule of Rates) Based Rate Analysis

SOR-based rate analysis uses standardized rates provided by government departments such as CPWD (Central Public Works Department) or PWD (Public Works Department).

Key points:

- Predefined rates for construction activities
- Updated periodically based on market trends
- Widely used in government and public sector projects

In this method, instead of calculating everything from scratch, engineers refer to the SOR book and apply the given rates to their project quantities. This approach ensures standardization and transparency.

FAQs

Q1. What is rate analysis in civil engineering?

It is the calculation of cost per unit work including material, labour, equipment, overheads, and profit.

Q2. What is the biggest mistake contractors make?

Ignoring:

- Overheads
- Wastage
- Labour productivity

Q3. How can machinery reduce cost?

Machines:

- Increase speed
- Reduce labour
- Improve quality

Q4. What is standard profit margin?

👉 10%–20%

Q5. What is SOR?

Schedule of Rates used in government projects.

Final Conclusion

Civil work rate analysis is not just a calculation — it’s a profit strategy.

If you master it:

- You win more tenders
- You avoid losses
- You increase margins

And the biggest advantage?

Using the right machines + accurate costing =
Maximum efficiency + Maximum profit
